Insulated Concrete Forms (ICFs)

Please Register or Login to Provide Feedback.

Climate

Accommodations must be made when pouring concrete in below-freezing conditions, but once in the forms concrete cures slowly and stays hydrated to produce a very strong assembly.

Please Register or Login to Provide Feedback.

Description

Insulated concrete form (ICF) construction combines concrete and rigid foam for walls that are thick, sturdy, and continuously insulated. Studies comparing ICFs with stick-frame construction have shown that in otherwise identical homes, the ICF houses had a 9% better whole-wall R-value and were 10% more airtight (Christian 1996). ICF walls have almost no thermal bridging in the wall itself and, with proper design details, thermal bridging can be almost eliminated at the rim joist as well (Petrie et al. 2003; Desjarlais et al. 2002).

ICFs are typically made of pre-molded blocks or panels of rigid foam, which are assembled on site to create wall forms into which concrete is poured (Figure 1). The foam forms stay in place, providing permanent insulating foam layers on the interior and exterior of the wall. Foam blocks are typically comprised of two 2-inch-thick, 16 by 48-inch rectangles of foam that are connected by plastic, metal, or foam ties. The ties hold the foam panels 6 or 8 inches apart during the pour and remain in place afterward. The blocks are stacked like bricks to create the wall forms for the concrete. Steel rebar is added to the cavities for additional strength (Figure 2). Some ICFs come with plastic nailing strips embedded in their exterior surfaces. The foam is typically expanded polystyrene (EPS). Some ICF products use extruded polystyrene (XPS) foam, which is stronger but more costly. A few products are made with recycled foam or wood. Some ICF walls consist of two layers of concrete sandwiching a central layer of foam.

ICFs provide continuous wall insulation from the roof to footing with very little thermal bridging; the ICFs in this home in Las Vegas provide R-40 wall insulation

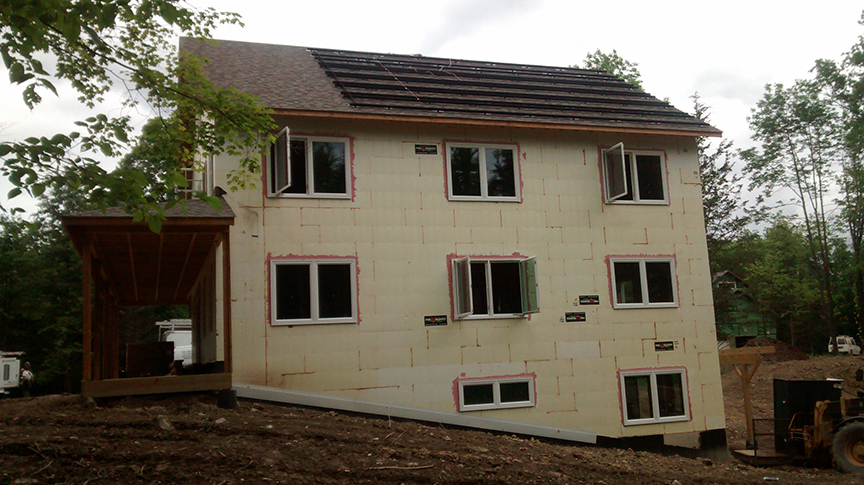

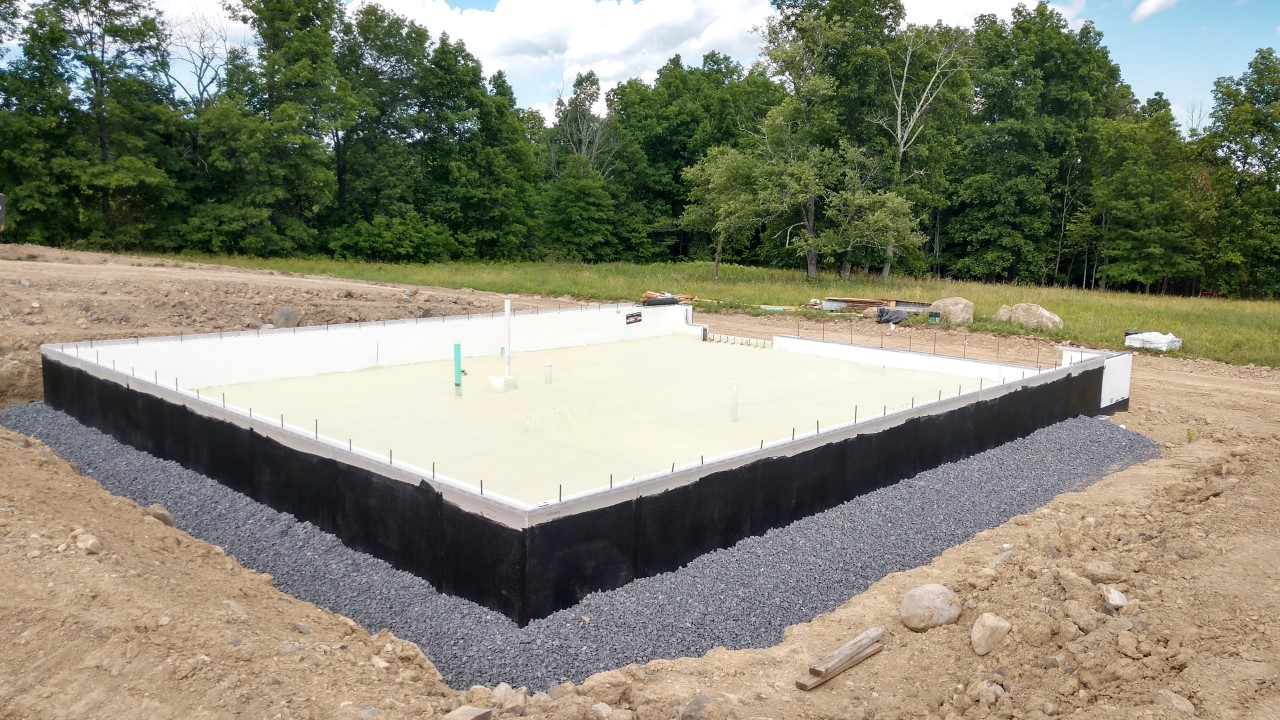

Figure 1 - ICFs provide continuous wall insulation from the roof to footing with very little thermal bridging; the ICFs in this home in Las Vegas provide R-40 wall insulation.  Reference

Common types of ICF walls are shown in Figures 3 and 4. A flat ICF wall system is a solid concrete wall of uniform thickness with sheets of insulation forming the interior and exterior surfaces of the system. The waffle-grid ICF wall system is a concrete wall composed of closely spaced vertical (maximum 12 inches on center) and horizontal (maximum 16 inches on center) concrete members with concrete webs between the members. The screen-grid ICF wall system is similar to a waffle-grid ICF wall system without concrete webs in between the vertical and horizontal members. The post-and­beam ICF wall system has vertical and/or horizontal concrete members spaced farther than 12 inches on center.

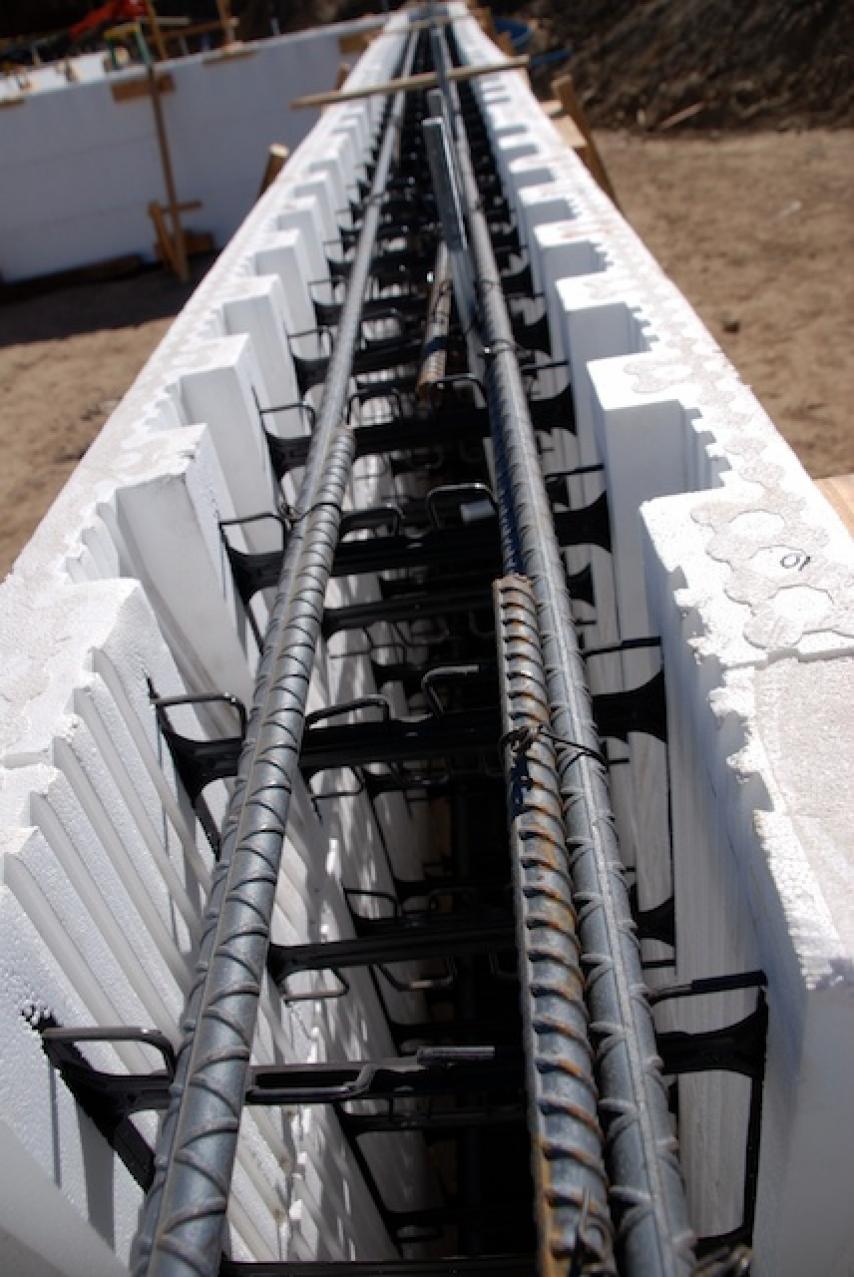

ICF systems are installed in a manner similar to masonry, starting at the corners and placing a layer at a time to build up the wall. Most manufacturers make specifically molded corner blocks that provide a continuous layer of foam around the corner to reduce thermal bridging there (Figure 5). Window and door openings must be framed with lumber (Figure 6). Lumber blocking is also needed where bearing pockets are required for floor or roof supports. Ledgers can be mounted to the blocks for attaching floor framing.

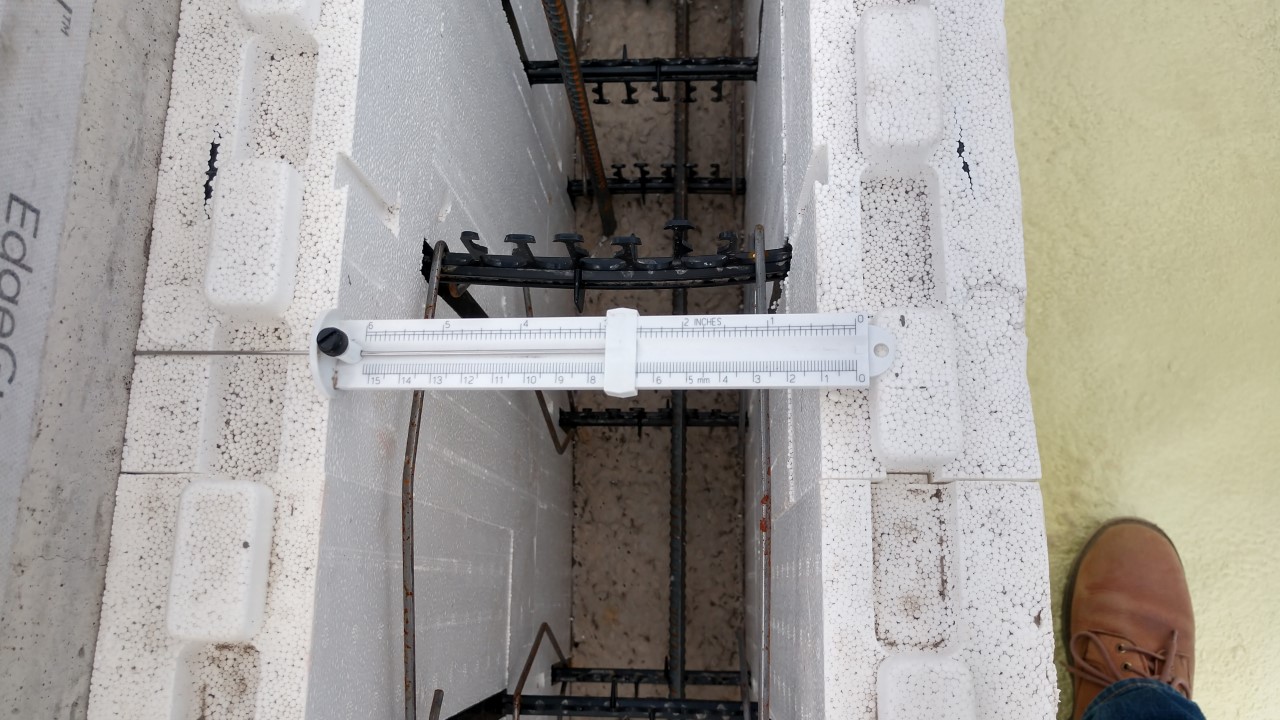

Once the forms are in place and braced, and required reinforcement is installed, concrete is pumped into the forms (Figure 7). Even with the bracing, the forms need to be filled at an appropriate rate based on the ICF manufacturer’s recommendations to prevent misalignment and blowouts. Form failures are rare when the manufacturer’s recommendations are followed. Reinforcement in both directions maintains the wall strength. A good item to have on hand when the concrete arrives is a blowout repair kit. Unless a self-consolidating concrete mix is used, concrete should be vibrated after pouring to remove trapped air as air pockets can lead to thermal bridging and weaken the cement (ICF Builder 2012).

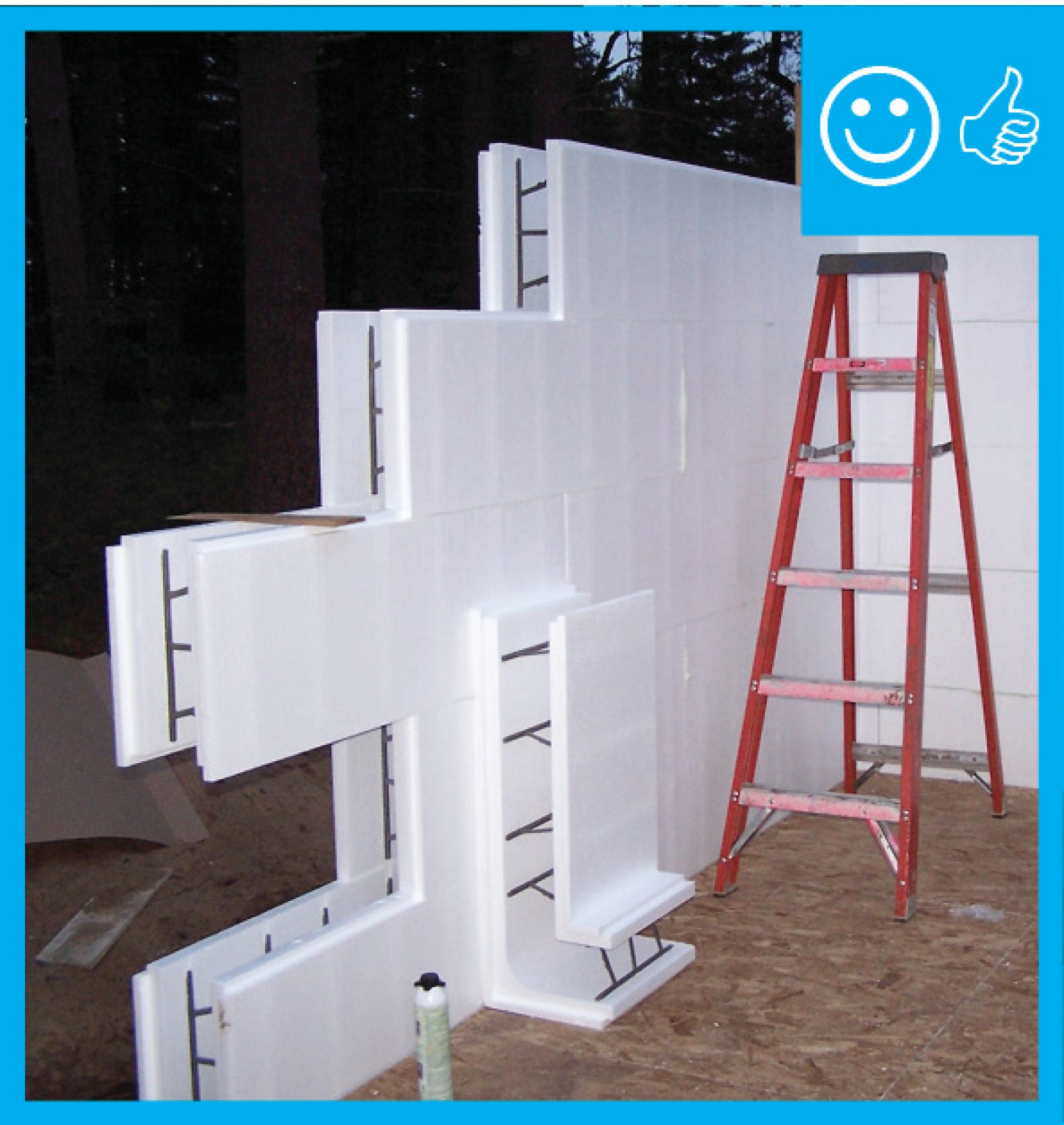

The ICF consists of wall forms made of rigid foam blocks or panels that are held in place with plastic or metal spacers and reinforced with metal rebar

Figure 2 -  The ICF consists of wall forms made of rigid foam blocks or panels that are held in place with plastic or metal spacers and reinforced with metal rebar.  Reference

Three common ICF wall systems: the flat wall, the waffle wall, and the post-and-beam wall.

Figure 3 - Three common ICF wall systems: the flat wall, the waffle wall, and the post-and-beam wall.  Reference

Different types of ICF blocks

Figure 4 - Different types of ICF blocks.  Reference

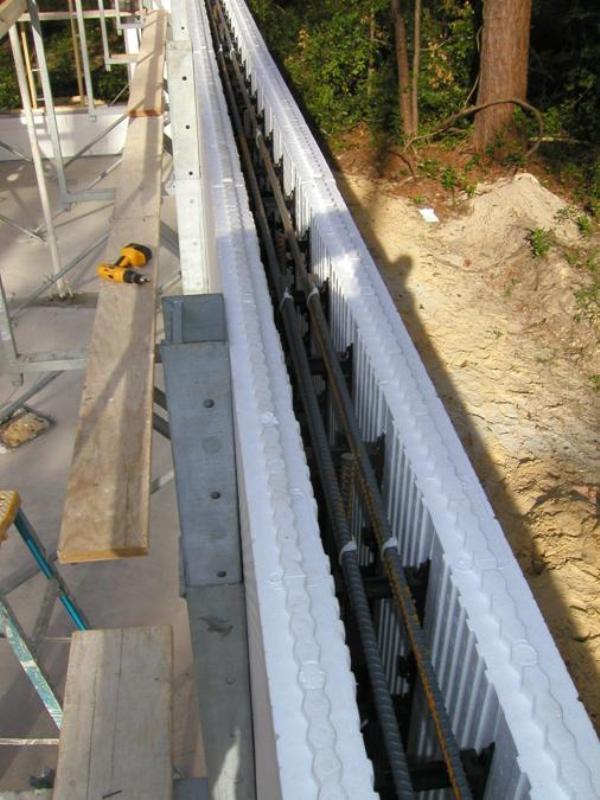

The blocks stack to form walls. Special molded corners provide continuous insulation layer at the corners to improve structural strength and minimize thermal bridging

Figure 5 - The blocks stack to form walls. Special molded corners provide continuous insulation layer at the corners to improve structural strength and minimize thermal bridging.  Reference

Window and door rough openings in the ICF wall are surrounded with pressure-treated wood

Figure 6 - Window and door rough openings in the ICF wall are surrounded with pressure-treated wood.  Reference

A pumper is used to place the concrete into the foam form walls

Figure 7 - A pumper is used to place the concrete into the foam form walls.  Reference

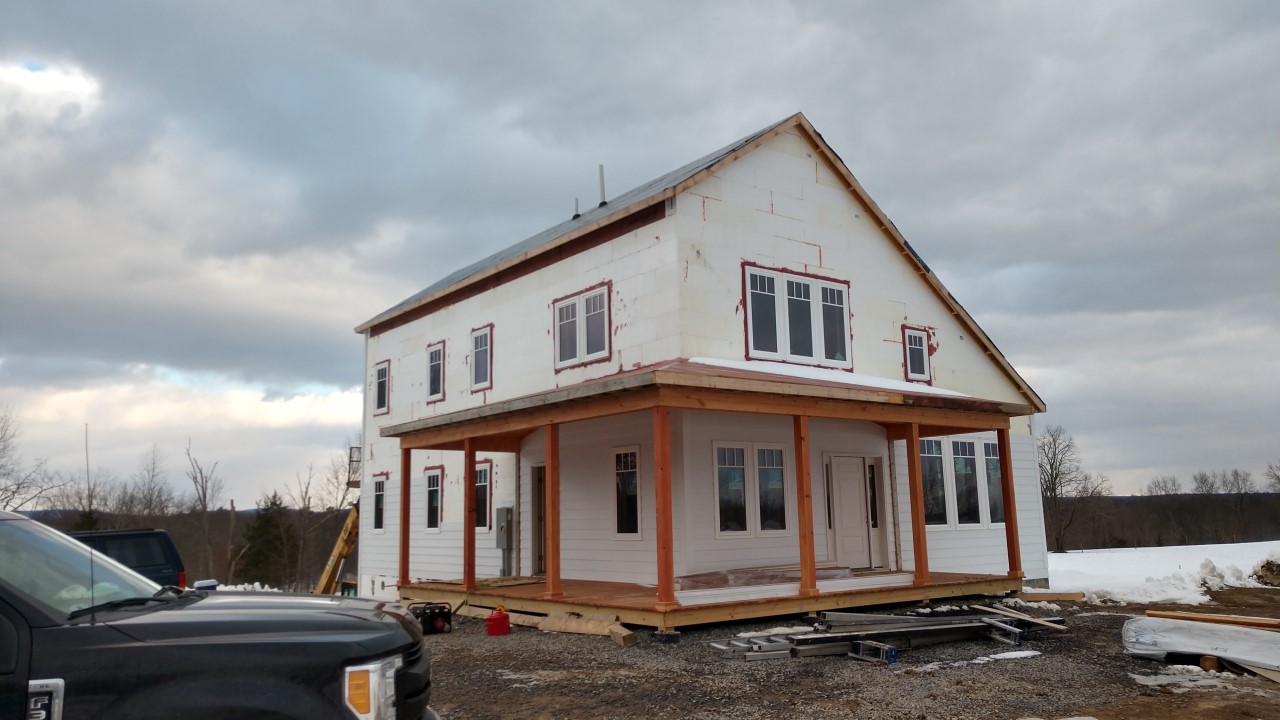

Depending on the specific system, the walls may allow attachment of exterior and interior wall coverings directly to the wall with little or no modifications to the wall. After finishes are applied inside and out, typical final wall thickness is greater than 1 ft. This means that window and door surrounds may be wider than is typical for frame construction, resulting in deeper window sills.

How to Install ICFs

Stacking (NAHB 2001)

  1. Place dowels (rebar) in footings, foundation wall, or slab as required.
  2. Place temporary braces along the first course to align the ICF forms and to prevent movement.
  3. Set blocks on concrete footings. Concrete can be recently placed and uncured.
  4. Place termite shield.
  5. Complete one course all the way around the building’s perimeter.
  6. Stagger subsequent courses so that vertical foam joints do not line up from one course to the next. Make sure vertical and horizontal cavities line up. Set horizontal and vertical rebar as required.
  7. Cut for openings as required (or cut out after entire wall is built).
    • Install bucks (2x4 or 2x6 wood framing) around the windows and doors as an attachment surface for windows and doors. A buck may be recessed, protruding, or "channel." Use pressure-treated wood for window framing and all other wooden structural components of the house (ICF Builder 2012, ICFA 2008). EPS foam that is not specifically treated to repel termites is not “resistant” to tunneling termites. EPS provides no food value for termites; however, they will tunnel through it searching for food and a place to live. Alternatively for window framing, use prefabricated plastic or vinyl bucks. Check all dimensions twice to make sure the rough opening can accommodate the actual window size. Enlarging a rough opening after the concrete has set is costly.

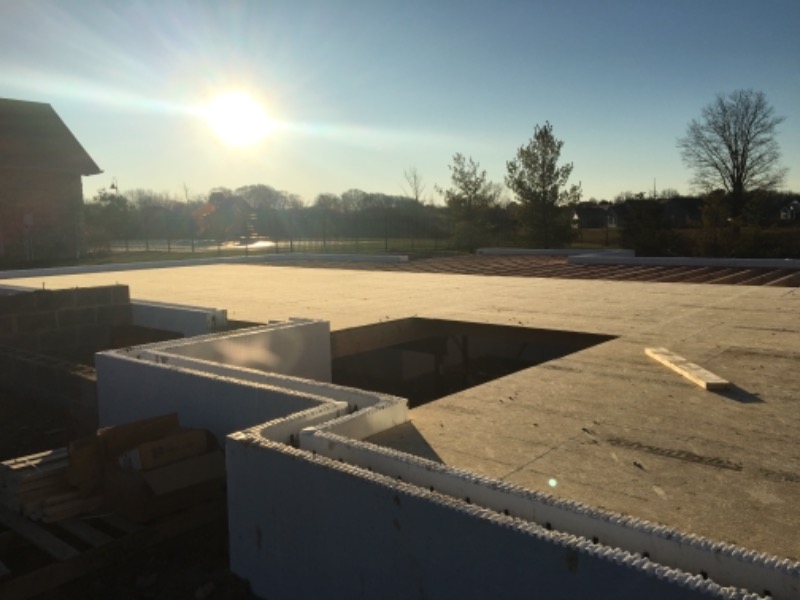

  8. Place intermediate floor connections and supports.
  9. Place sleeve penetrations for dryer vents, electrical, HVAC, cable, telephone, solar, and plumbing services, and outside fixtures and outlets.
  10. Locate and mark block beam pockets.
  11. Reinforce and support the block brick ledge (if applicable).

Bracing

  1. Brace the wall forms every 6 feet with strong temporary bracing to ensure they stay level, plumb, square, and straight during the concrete pour and to support the weight of the concrete until it achieves the desired strength. Bracing is needed at corners, window and door openings, periodically along the length of walls, and at the top of the forms. Window and door bucks are braced inside horizontally and vertically (see Figure 8). Top braces square the forms and provide a surface to check wall height and cut uneven blocks. Follow manufacturer’s recommendations completely.

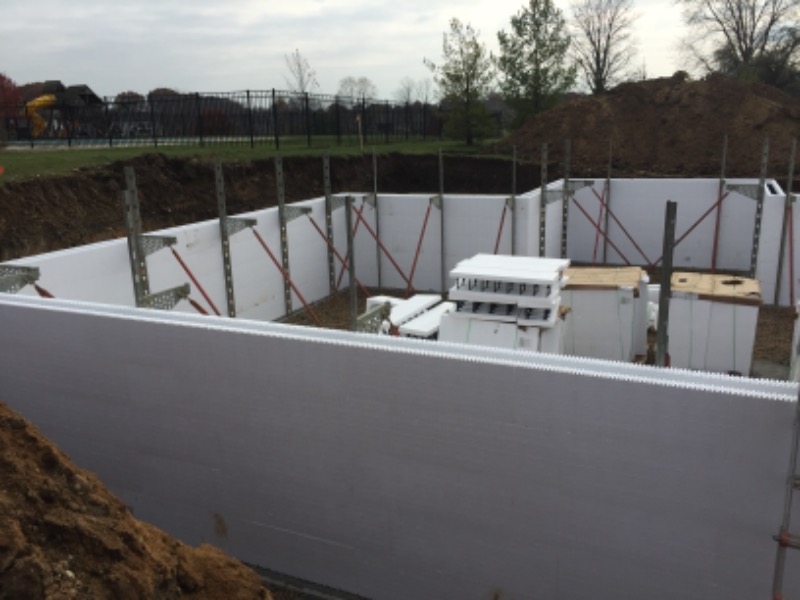

The ICF walls of this home are braced to prepare for pouring the concrete

Figure 8 - The ICF walls of this home are braced to prepare for pouring the concrete.  Reference

2.  Place anchor bolts and ledgers as required. Floor system attachment options include ledgers, pockets, embedded joist hangers, or direct bearing. Ledgers may be made of wood that is either pressure treated or installed with a water-resistant membrane (Figure 9). Bolts and ledgers are placed before the pour, with foam cutouts around bolts to allow concrete to back up the ledger. (The ledger face must not "bear" only on foam.) Embedded joists require cutting out the foam and inserting wood spacers before the pour to create a pocket in which to seat the joist. Some code authorities also require the embedded joist to be fire-cut. See details provided by manufacturer.

3.  Place sleeves for any services such as wiring and piping.

4.  Foam seal joints (possibly per course) to secure blocks until concrete is poured and to maintain airtight construction.

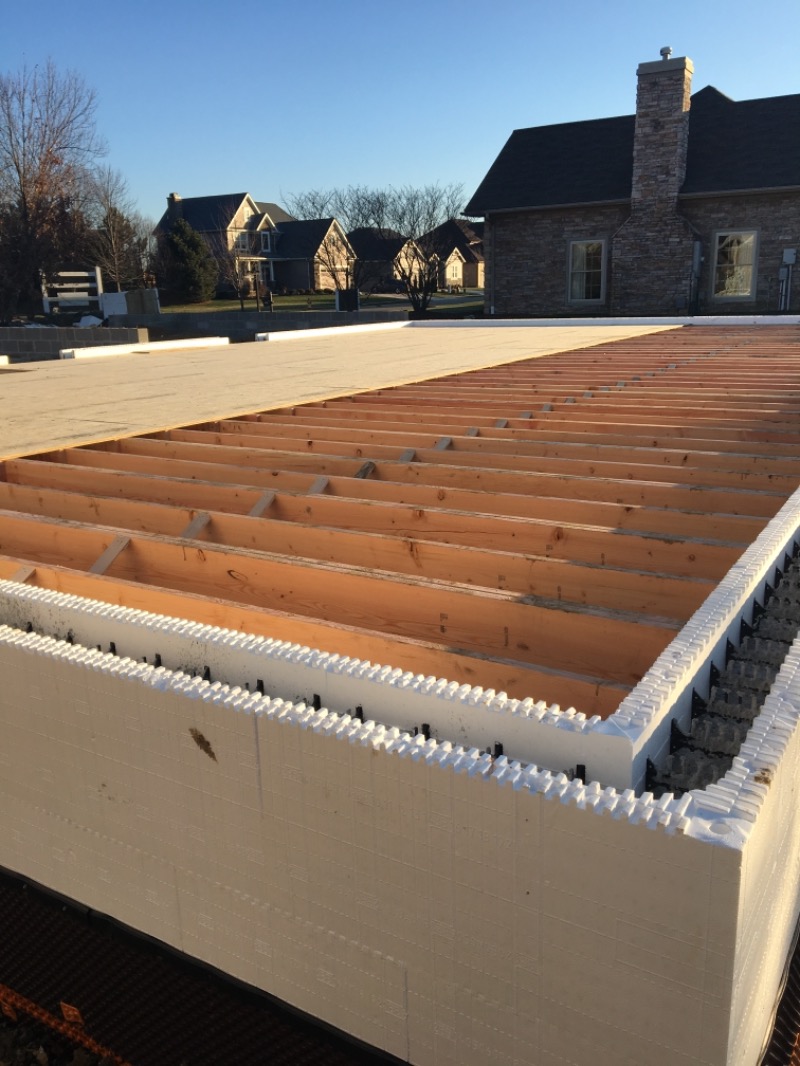

Thermal bridging is eliminated at the rim joist with the use of joist ledgers that are anchored in the wall

Figure 9 - Thermal bridging is eliminated at the rim joist with the use of joist ledgers that are anchored in the wall.  Reference

Pouring (ICF Systems 2013

1. Go through the pre-pour checklist.

Pre-pour checklist

2.  Confirm the concrete order with the dispatcher.

      • Make sure the correct amount of concrete has been ordered, trucks are spaced correctly, and the proper mix design and slump are specified.
      • Order a second truck to be shipped when called. Space all subsequent trucks at 45-minute intervals; holding the final truck on call for any adjusted amount.
      • When ordering, tell them your order will be pumped, it is for an ICF wall, and that you will have to send back any trucks that arrive with more than a 6.5” slump. Add water if necessary at the site to correct the proper slump.
      • Order the correct mix. Work with your ready-mix supplier prior to the pour to make sure they understand the concrete specifications and parameters that ICFs require.

3.  Choose the concrete pouring equipment.

      •  Use a line pump or a boom pump to place the concrete. Line pumps, also called trailer pumps, are more labor intensive than boom pumps because the hose must be manually moved and lifted into position. The hourly rates for line pumps are much lower than those for a boom pump, but often the total cost is the same, because they take longer to set up, pump, and take down and they require more manpower. Boom pumps, as shown in Figure 10, can get the job done faster if everyone is properly prepared. Boom pumps are specified by their reach. Most residential jobs use 28, 32, or 36 meter booms. If the boom is much longer than needed, place the truck further from the wall to level out the boom and lower the fall of the concrete.
      • Reduce the hose width to at least 3 inches. If possible, use an elbow, rams horn, or other attachment at the end of the hose to break the fall and collect the concrete coming through the boom.
      • Use a steady pour rate, not pulsing or stopping and starting. It should take about 20 minutes to pour 8 yards of concrete.
      • Be aware of any overhead power lines when working with boom equipment. Under certain temperature and humidity conditions, electricity can jump from overhead lines to the boom with disastrous consequences. If you have any concern, consult the pump company and request that the local utility company shield the lines during the pour.

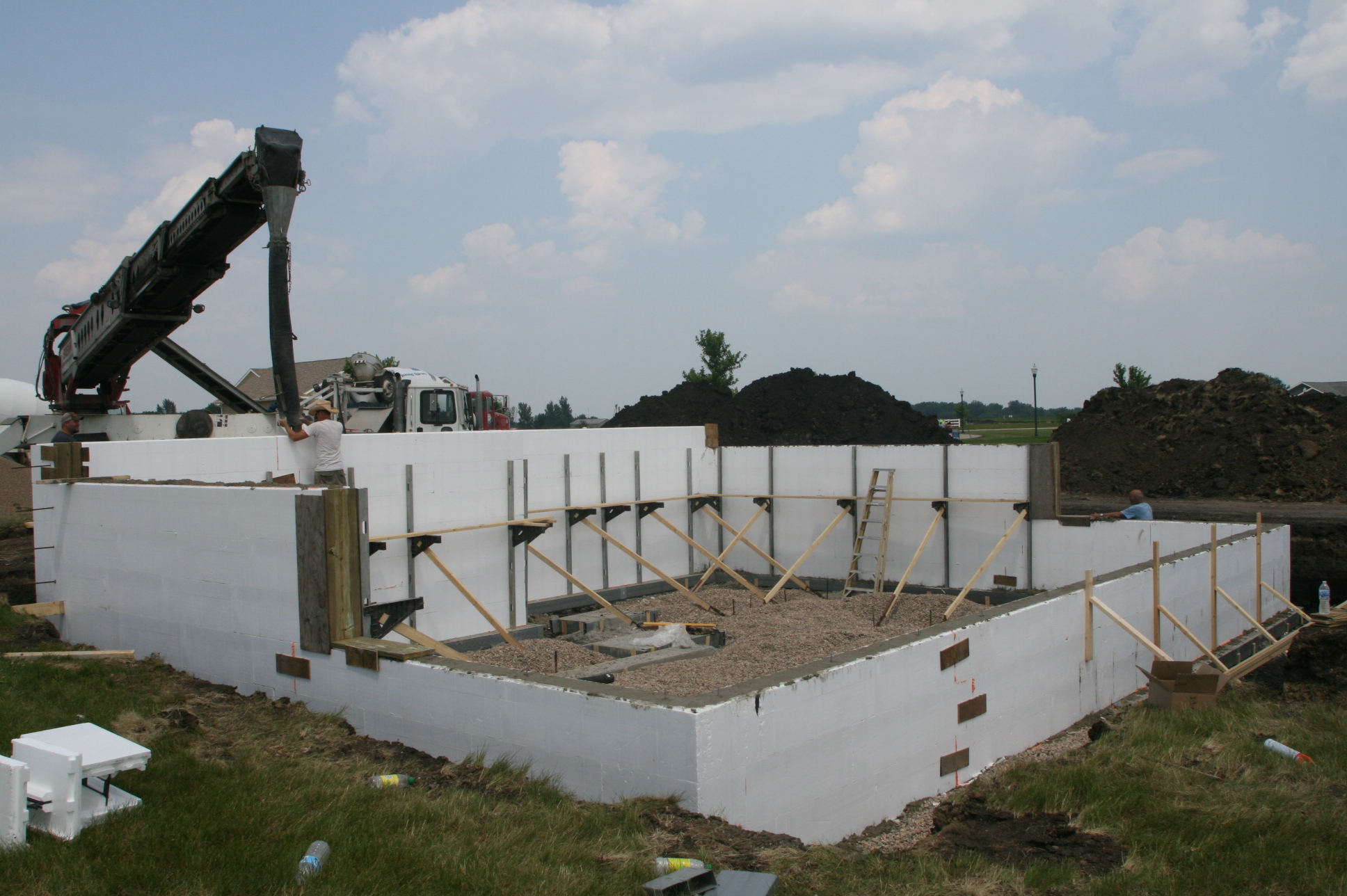

ICF forms are filled with the use of a concrete pumper truck

Figure 10 - ICF forms are filled with the use of a concrete pumper truck.  Reference

4. Manage the Pour

      •  Check the concrete in each new truck when it arrives to make sure that the slump is correct. Make sure the pump operator and each ready-mix driver understand that no water is to be added without your approval. A wetter mix will make their job easier but can impact quality. If the concrete arrives too wet, you have to decide to send the truck back or wait until it tightens up. If you decide to pump, know that you cannot do lifts very high and may have to take more laps around the walls. If you need to increase the slump, one gallon of water will increase one cubic yard of concrete by one inch.
      • Be ready to pour when the trucks arrive.
      • Have adequate manpower on hand. Pump day can be exhausting, don't be light on manpower.

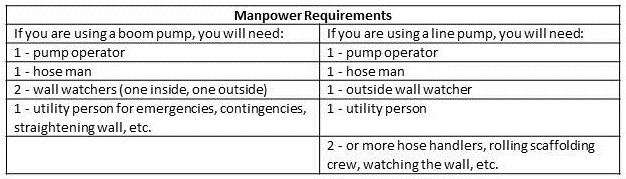

Manpower requirements

5. Have the right tools on hand. A properly equipped team will make the pour easier, more efficient, and result in a cleaner, more professional, finished product.

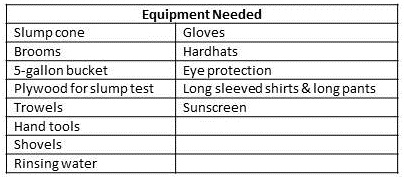

Equipment needs

6. Pouring the Concrete

      •  Make sure your scaffolding or walk boards (or other method of getting around the top of the wall) are correct and safe. Raise the scaffolding as needed so the hose man is standing at approximately waist height to the top of the wall. If the top of the wall is above the waist, handling the hose is very fatiguing and the hose man will not be able to see both sides of the wall (See Figure 11).

Scaffolding is continually raised as courses of foam brick are added so that that the pour man can see both sides of the wall during the pour.

Figure 11 - Scaffolding is continually raised as courses of foam brick are added so that that the pour man can see both sides of the wall during the pour.  Reference

      •  Have a second person with the hose man to tell him where the concrete is in each section and when to move.
      • With the first yard start the fill below a window so you can see the mix and slump; or begin near a corner with a window within 4 feet. Avoid placing concrete directly into the corners. Fill by moving toward the window and watch the concrete fill up to the bottom of the window, then move to the other side of the window starting approximately 4 feet away and fill back toward the window to lock in the other side. As a precautionary measure, you can pump the first yard back into the ready-mix truck and blend it with the 6 or more yards remaining in the mixer, after the pump operator has already primed out.
      • Plan to get beyond the 32-in. level (above the seam of the second course of forms) with the first lift. Most houses, up to a 12-foot wall height, will require three passes for a complete fill.
      • Have someone trail the hose man to scrape and shake any concrete that may build up on the top of the forms or sit on top of the rebar. This will help prevent voids.
      • While filling the walls on the second pass, do not fill too close to the top; stay at least 24 inches down from the top course and do not fill over doors and windows until the last pass. One exception to this rule is that on deep lintels (over 32 inches), you may want to pour a small amount to begin to form the lintel and load the window.
      • For the last pass, to the top of the wall, you may want to increase the slump by adding water. The increase in slump will allow you to more effectively fill the top of the wall and will give you more time to trowel the top of the wall and set straps or anchor bolts. Tap or vibrate the outside of the wall for proper consolidation, especially over lintels where extra rebar and stirrups can prevent good compaction.

7. Fix blowouts.

      •  Pay close attention when pouring to avoid over-pouring and bulges or blowouts. Blowouts in ICFs are simple to fix. Blowouts often occur where the foam is damaged and not patched or when there is too much water in the cement mix.
      • To repair, clean up the spillage and place the broken foam pieces back in the wall. Cover the damaged area with a piece of half-inch OSB and screw the OSB to the furring strips. For larger blowouts, place pieces of OSB on both sides of the wall at the location of the blowout. Clamp them in place with a threaded-bar inserted through the wall and both pieces of OSB.

8. Perform a final inspection and cleanup.

      •  Inspect the job to see if you have missed anything.
      • Check to see if the walls have moved (the earlier in the pour you notice a bow, the easier it is to correct).
      • Confirm that you have good fill. Cross check the amount of yardage you estimated the walls would require with the load tickets, and know how much yardage you may have left over. Having a yard or two extra is less costly than bringing a truck back with one or two yards.
      • Did you over-fill at a door threshold location or forget a beam pocket? It will be easier to dig out the concrete today than it will be tomorrow.

Installing Utilities and Attaching Cladding and Interior Finish Material

      • Install wiring and plumbing in recesses cut into the foam after the concrete has been poured (Figure 12). Be sure to cover with metal plates to avoid nailing into wires.

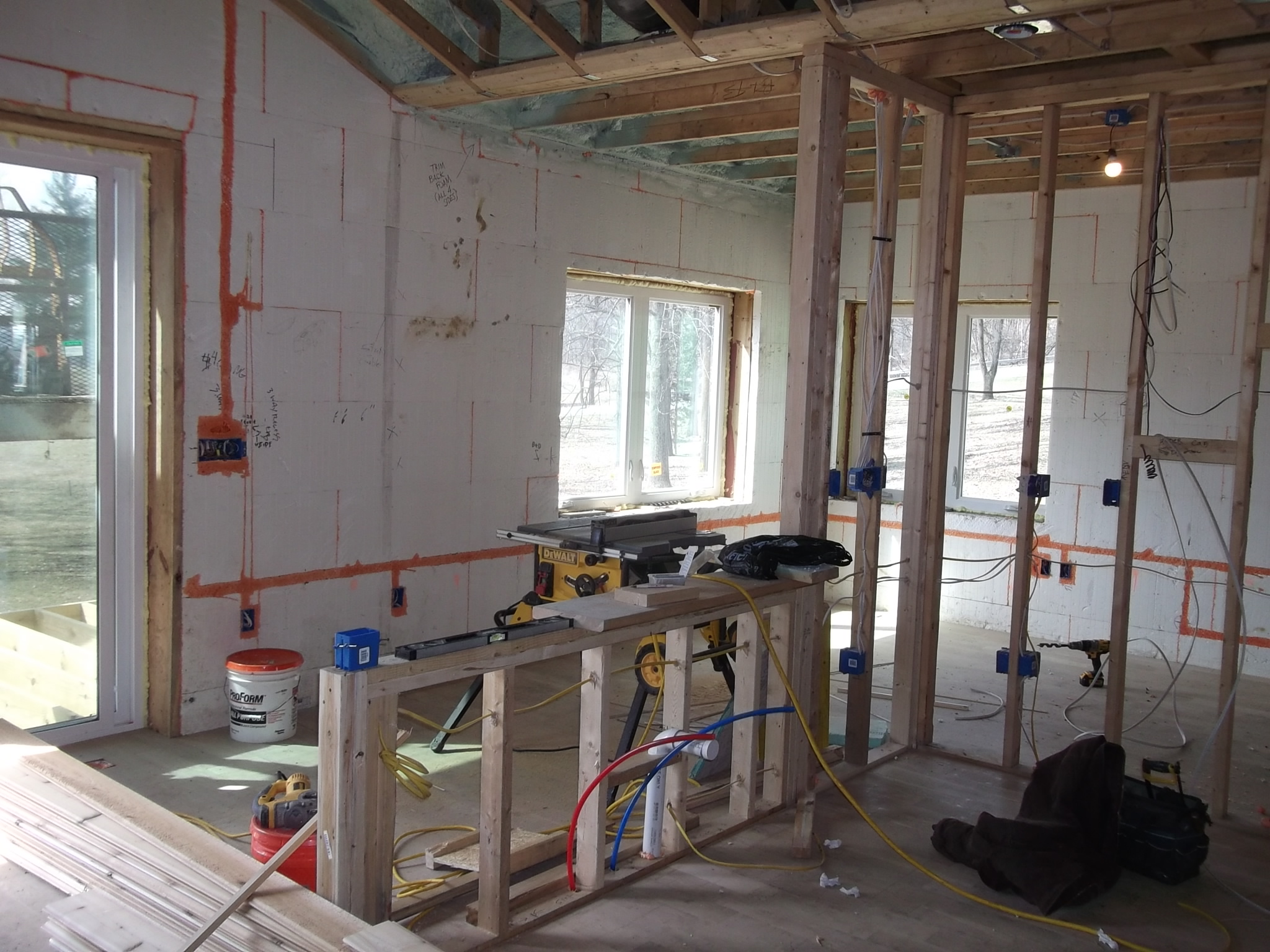

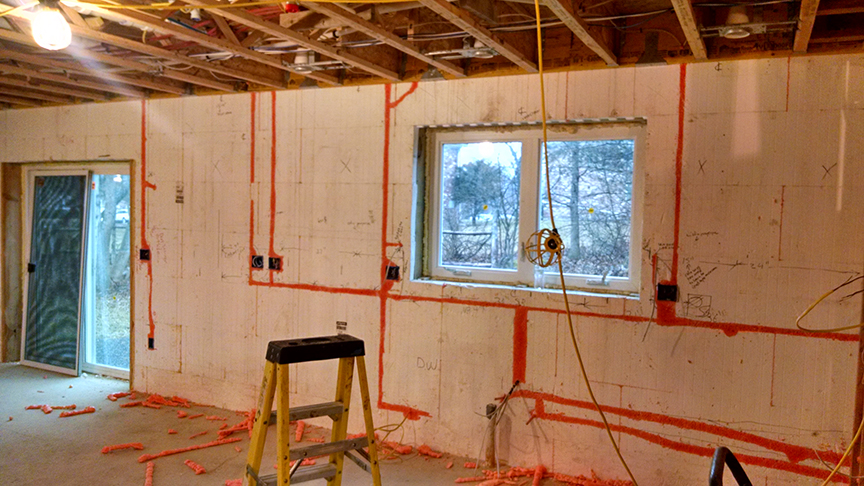

Utilities are commonly recessed into cutouts in the foam after concrete has been poured

Figure 12 - Utilities are commonly recessed into cutouts in the foam after concrete has been poured.  Reference

      •  Apply waterproofing on the exterior side of any sub-grade structure to prevent water intrusion (see Figure 13).

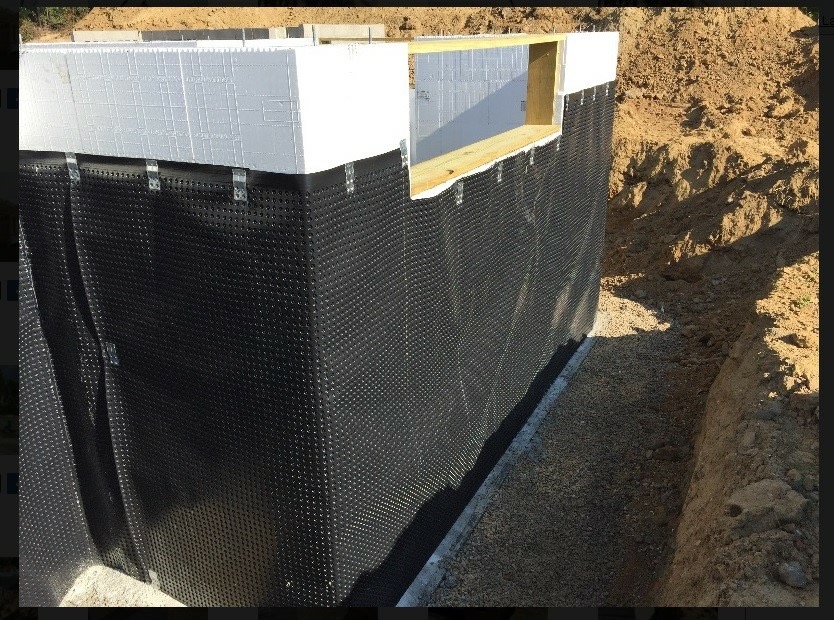

Install waterproofing on portions of the ICF that will be below grade

Figure 13 - Install waterproofing on portions of the ICF that will be below grade. The waterproofed R-25 ICF blocks shown here are installed starting 30 inches below grade to provide a frost-protected foundation and perimeter insulation for the slab floors of this cold climate home.  Reference

      •  Attach interior drywall and exterior cladding finishes to the flat ends of metal or plastic ties embedded in the rigid foam. Finishes can also be furred out. Gypsum drywall is the most common interior finish and meets the code requirement for a 15-minute fire barrier over plastic foams surrounding living spaces. Exterior claddings are much more varied but regardless of the cladding type, a drainage layer is recommended between the ICFs and the exterior cladding.

Ensuring Success

Use crews that are trained in insulated concrete form (ICF) construction. Before concrete is poured, the site supervisor should inspect the ICF forms to ensure that they are properly installed and well supported and should measure to ensure that blocked openings are properly sized and correctly placed for doors, windows, penetrations, and mounting elements for floors and roofs. Infrared scans can be performed during construction to verify that the concrete layer is consistent.

Scope

Insulated concrete forms (ICFs)

Reduced Thermal Bridging

Insulated Concrete Forms (ICFs)

  1. Install ICFs according to manufacturer specifications to create a continuous air barrier and thermal boundary.

ENERGY STAR Notes:

Only one item from 4.4.1 through 4.4.5 on the ENERGY STAR checklist must be installed to comply with ENERGY STAR.

Mass walls utilized as the thermal mass component of a passive solar design (e.g., a Trombe wall) are exempt from this Item. To be eligible for this exemption, the passive solar design shall be comprised of the following five components: an aperture or collector, an absorber, thermal mass, a distribution system, and a control system. See DOE's guidance for passive solar home design.

Mass walls that are not part of a passive solar design (e.g., CMU block or log home enclosure) shall either utilize the strategies outlined in Item 4.4 (of the ENERGY STAR Thermal Enclosure System Rater Checklist). Or, the pathway in the assembly with the least thermal resistance, as determined using a method consistent with the 2009 ASHRAE Handbook of Fundamentals, shall provide >= 50% of the applicable assembly resistance, defined as the reciprocal of the mass wall equivalent U-factor in the 2009 IECC – Table 402.1.3. Documentation identifying the pathway with the least thermal resistance and its resistance value shall be collected by the rater and any Builder Verified or Rater Verified box under Item 4.4 (of the ENERGY STAR Thermal Enclosure System Rater Checklist) shall be checked.

Up to 10% of the total exterior wall surface area is exempted from the reduced thermal bridging requirements to accommodate intentional designed details (e.g., architectural details such as thermal fins, wing walls, or masonry fireplaces; structural details, such as steel columns). It shall be apparent to the Rater that the exempted areas are intentional designed details or the exempted area shall be documented in a plan provided by the builder, architect, designer, or engineer. The Rater need not evaluate the necessity of the designed detail to certify the home.

Training

Right and Wrong Images

Presentations

None Available

Videos

None Available

CAD Images

Compliance

ENERGY STAR Version 3, (Rev. 07)

Thermal Enclosure Checklist, Reduced Thermal Bridging. Mass walls utilized as the thermal mass component of a passive solar design (e.g., a Trombe wall) are exempt from this Item. To be eligible for this exemption, the passive solar design shall be comprised of the following five components: an aperture or collector, an absorber, thermal mass, a distribution system, and a control system. See DOE's guidance for passive solar home design. Mass walls that are not part of a passive solar design (e.g., CMU block or log home enclosure) shall either utilize the strategies outlined in Item 4.4 (of the ENERGY STAR Thermal Enclosure System Rater Checklist). Or, the pathway in the assembly with the least thermal resistance, as determined using a method consistent with the 2009 ASHRAE Handbook of Fundamentals, shall provide >= 50% of the applicable assembly resistance, defined as the reciprocal of the mass wall equivalent U-factor in the 2009 IECC – Table 402.1.3. Documentation identifying the pathway with the least thermal resistance and its resistance value shall be collected by the rater and any Builder Verified or Rater Verified box under Item 4.4 (of the ENERGY STAR Thermal Enclosure System Rater Checklist) shall be checked. Up to 10% of the total exterior wall surface area is exempted from the reduced thermal bridging requirements to accommodate intentional designed details (e.g., architectural details such as thermal fins, wing walls, or masonry fireplaces; structural details, such as steel columns). It shall be apparent to the Rater that the exempted areas are intentional designed details or the exempted area shall be documented in a plan provided by the builder, architect, designer, or engineer. The Rater need not evaluate the necessity of the designed detail to certify the home.

DOE Challenge Home

Exhibit 1: Mandatory Requirements. Certified under ENERGY STAR Qualified Homes Version 3. Ceiling, wall, floor, and slab insulation shall meet or exceed 2012 IECC levels and achieve Grade 1 installation, per RESNET standards.

2009 IECC

ICFs are not specifically addressed in the 2009 IECC.

2009 IRC

Although insulated concrete forms are addressed in the 2009 IRC in Section R611, thermal bridging is not specifically addressed.

2012 IECC

ICFs are not specifically addressed in the 2012 IECC.

2012 IRC

Although insulated concrete forms are addressed in the 2009 IRC in Section R611, thermal bridging is not specifically addressed.

ASTM E2634-11

Standard for Flat Wall Insulating Concrete Form (ICF Systems). This Specification is intended to apply to ICF Systems that will act as permanent formwork for cast-in-place reinforced concrete beams; lintels; exterior and interior, above and below grade bearing and non-bearing walls; foundation; and retaining walls. In addition, this Specification is restricted to ICF Systems with a resultant uniform monolithic concrete core.

More Info.

Case Studies

  1. Author(s): PNNL
    Organization(s): PNNL
    Publication Date: January 2013

    Case study about the first certified DOE Challenge Home—the “Wilson Residence” in Winter Park, Florida.

  2. Author(s): PNNL
    Organization(s): PNNL
    Publication Date: January 2013

    Case study about the first certified DOE Challenge Home—the “Wilson Residence” in Winter Park, Florida.

  3. Author(s): PNNL
    Organization(s): PNNL
    Publication Date: February 2013

    Case study about 50% energy savings projects for new multifamily homes in cold climates.

  4. Author(s): PNNL
    Organization(s): PNNL
    Publication Date: October 2012

    Case study about incorporating inuslating concrete forms (ICFs) into new home design and construction.

References and Resources*

  1. Author(s): Portland Cement Association
    Organization(s): Portland Cement Association
    Publication Date: January 2012

    Information sheet discussing the properties and benefits of insulating concrete forms.

  2. Author(s): ICF Builder
    Organization(s): ICF Builder
    Publication Date: January 2012

    Information sheet disucssing myths about insulated concrete forms.

  3. Author(s): DOE
    Organization(s): DOE
    Publication Date: June 2013

    Standard requirements for DOE's Challenge Home national program certification.

  4. Author(s): BSC
    Organization(s): BSC
    Publication Date: June 2009

    Information sheet with details on building high R-value wall assemblies in new homes.

  5. Author(s): EPA
    Organization(s): EPA
    Publication Date: June 2013

    Standard document containing the rater checklists and national program requirements for ENERGY STAR Certified Homes, Version 3 (Rev. 7).

  6. Author(s): Maref, Armstrong, Saber, Rousseau, Ganapathy, Nicholls, Swinton
    Organization(s): National Research Council Canada
    Publication Date: March 2012

    Research study evaluating the dynamic heat transmission characteristics through two identical Insulating Concrete Form (ICF) wall assemblies in Ottawa, Canada.

  7. Author(s): Desjarlais, Kosny, Christian
    Organization(s): ORNL
    Publication Date: December 2001

    Presentation about results from an insulating concrete form energy efficiency study in Knoxville, TN.

  8. Author(s): Owens Corning
    Organization(s): Owens Corning
    Publication Date: January 2007

    Information sheet with manufacturer specifications about insulated concrete forms.

  9. Author(s): DOE
    Organization(s): DOE
    Publication Date: January 2009

    Case study of new home construction in the hot-dry and mixed-dry climate zones.

  10. Author(s): Petrie, Kosny, Desjarlais, Atchley, Childs, Ternes, Christian
    Organization(s): ORNL
    Publication Date: January 2003

    Report sumarizing results of an ICF investigation of side-by-side houses in Knoxville, Tennessee.

  11. Author(s): Portland Cement Association
    Organization(s): Portland Cement Association
  12. Author(s): ARXX Building Products
    Organization(s): ARXX Building Products
  13. Author(s): Sculthorpe
    Organization(s): ORNL

    Report sumarizing a workshop to initiate a professional discussion about eventual benefits of the application of massive technologies in US buildings.

  14. Author(s): BSC
    Organization(s): BSC
    Publication Date: June 2009

    Information sheet summarizing ICF wall construction including the advantages and disadvantages of this construction strategy.

  15. Author(s): Insulated Concrete Forms Association
    Organization(s): Insulated Concrete Forms Association
    Publication Date: January 2008

    Document with information on preventing termites when using ICFs.

  16. Author(s): NAHB Research Center
    Organization(s): NAHB Research Center
    Publication Date: January 2001

    Information sheet with construction details, pros and cons of insulated concrete forms.

  17. Author(s): Kosny, Christian, Desjarlais, Kossecka, Berrenberg
    Organization(s): ASHRAE
  18. Author(s): ICF Systems
    Organization(s): Massachusetts Building Products
    Publication Date: January 2013

    Information sheet including a checklist of steps to follow for pouring concrete.

  19. Author(s): NREL
    Organization(s): NREL
    Publication Date: December 2008

    Case study of new home construction in the hot-dry and mixed-dry climate zones.

  20. Author(s): EPA
    Organization(s): EPA
    Publication Date: October 2011

    Guide describing details that serve as a visual reference for each of the line items in the Thermal Enclosure System Rater Checklist.

  21. Author(s): Christian, Kosny
    Organization(s): ORNL
    Publication Date: March 1996

    Report proposing a procedure for estimating the whole opaque wall R-value (whole-wall R-value), independent of system type and construction materials.
